Home | Training | Week 67 | 66 | 65 | 64 | 63 | JAN 2017 | 62 | 61 | 60 | 59 | 58 | 57 | 56 | 55 | NOV | 54 | 53 | 52 | 51 | 50 | 49 | 48 | 47 | 46 | SEP | 45 | 44 | 43 | 42 | 41 | 40 | 39 | 38 | JUL | 37 | 36 | 35 | 34 | 33 | 32 | 31 | 30 | MAY | 29 | 28 | 27 | 26 | 25 | 24 | 23 | 22 | 21 | MAR | 20 | 19 | 18 | 17 | 16 | 15 | 14 | 13 | JAN 2016 | 12 | 11 | 10 | 9 | 8 | 7 | 6 | 5 | NOV | 4 | 3 | 1&2 | SEP 26 2015 | Archives

Search this site Full results

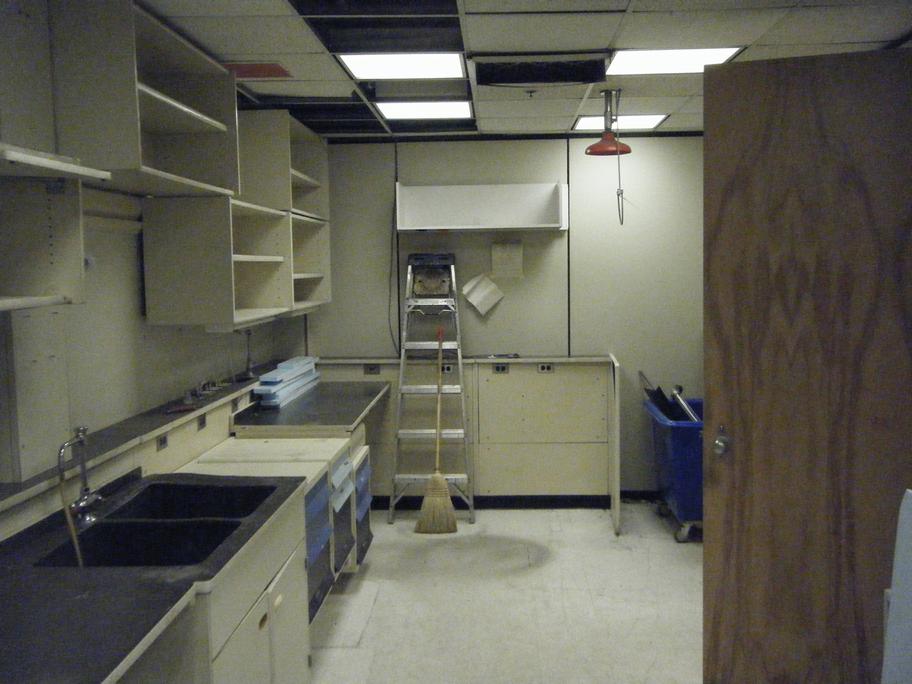

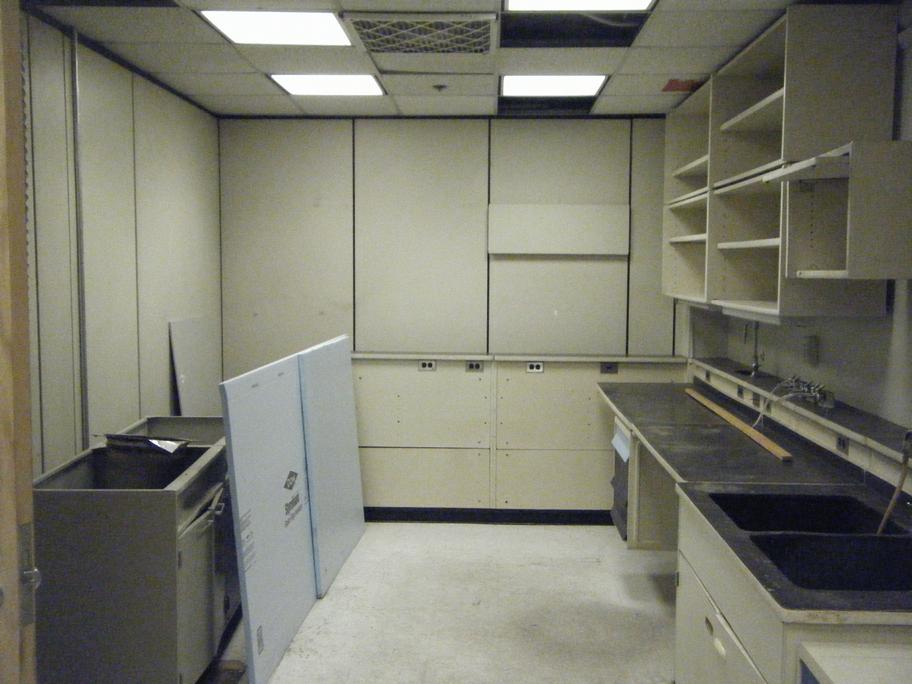

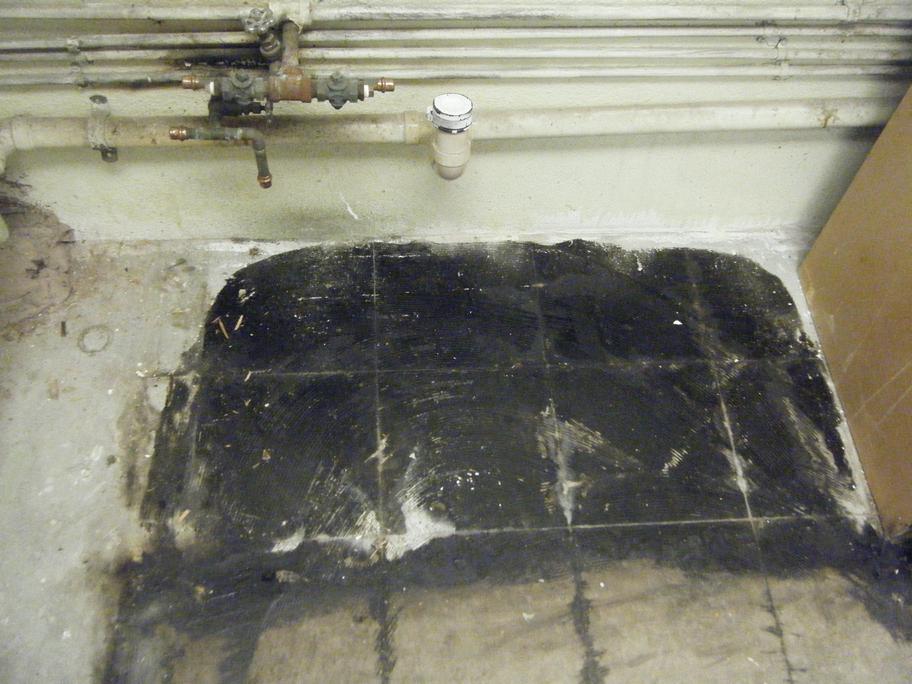

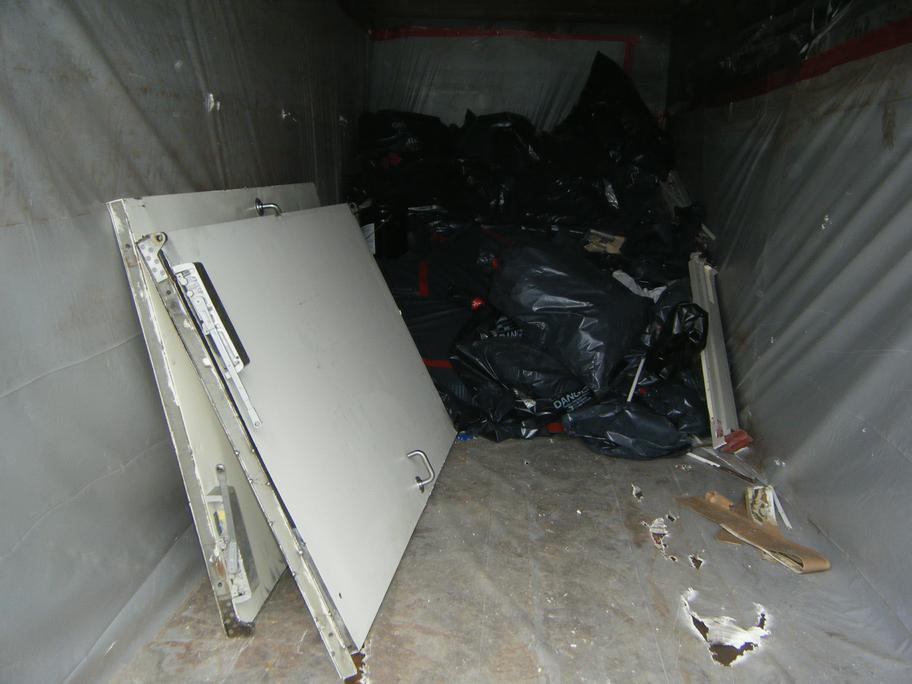

Fri 2-3-2017. Jordan 1071. Haul away Neg Air, scaffold, ladder, final cleanup.

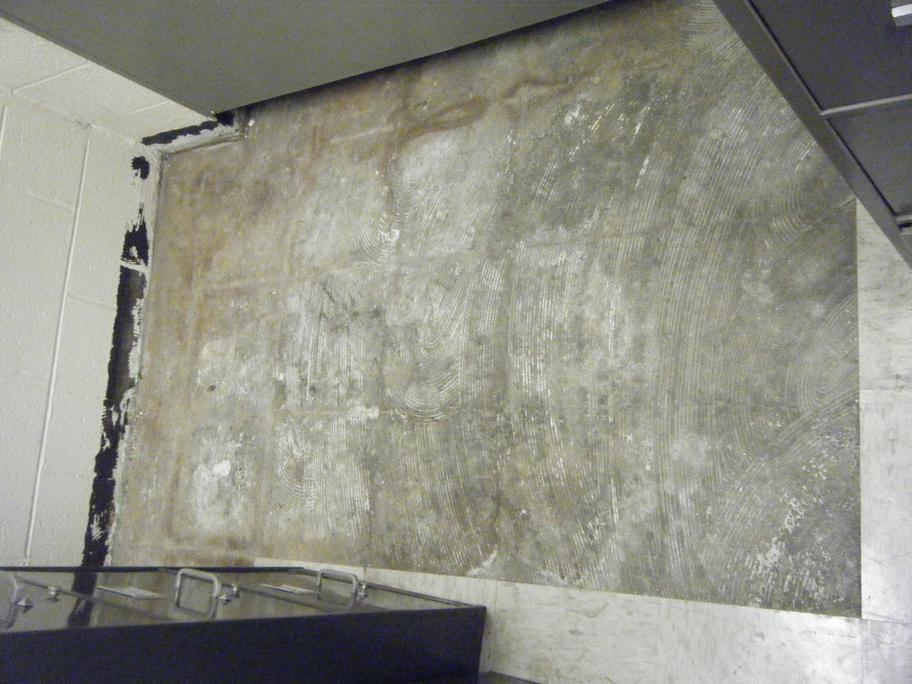

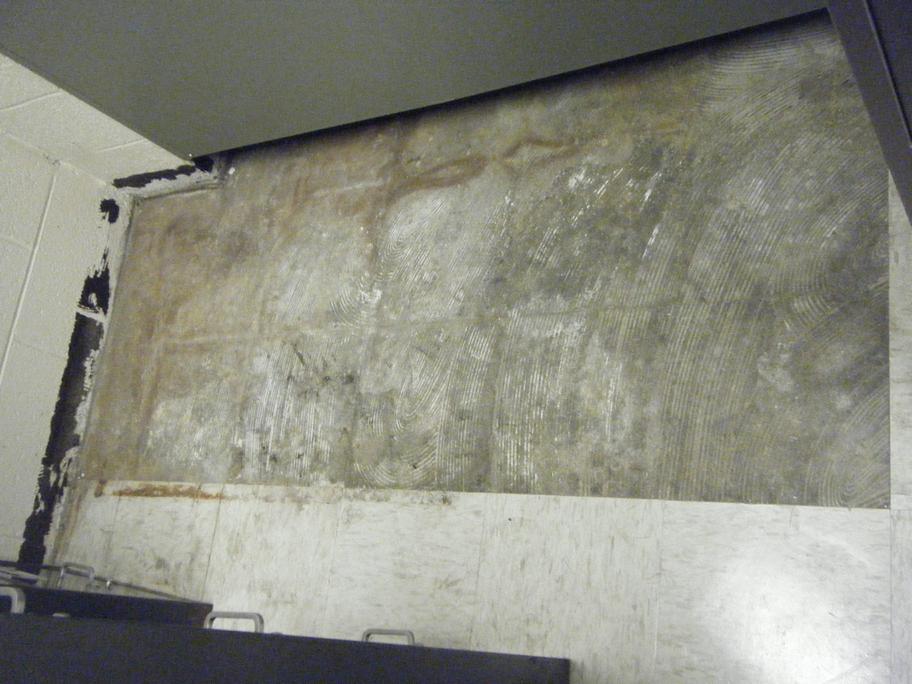

Cobb 2005. Mastic below fumehood before renovation. Last abatement Week 65.

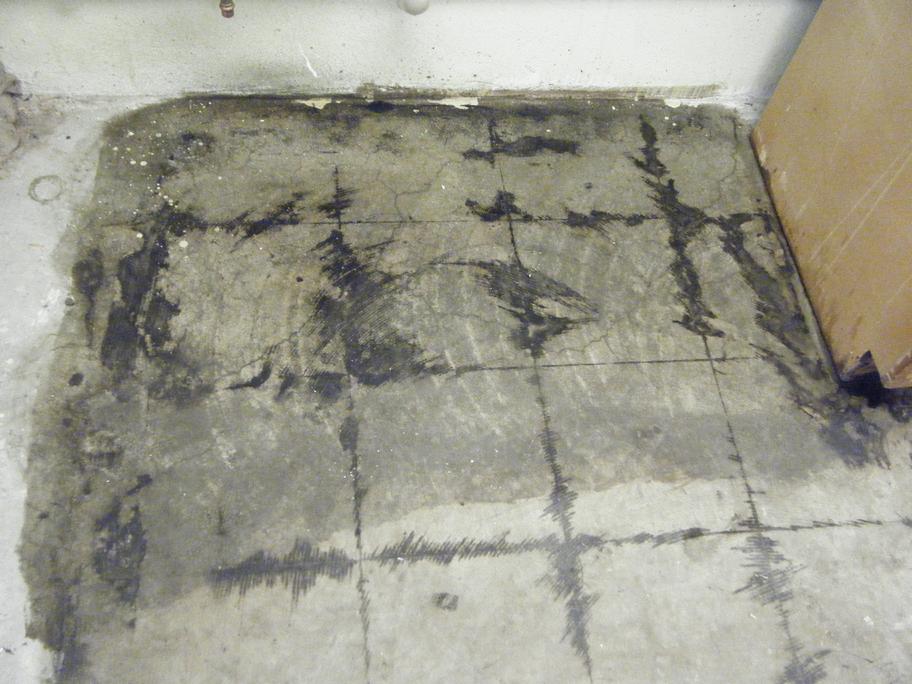

Fontana Printshop. Remove 7 vynil floor tile.

JAG School. 3 jobs to be scheduled. Women's Lounge Room 110 behind security desk. Renovate to include demo asbestos-containing sheetrock. B017 two rooms and hallway. Floor tile / Mastic full containment. B096 is the fixed ladder access. 5th Floor alumni bar expansion. Acoustical asbestos spray-on underside of sink. Possibly in stone bottom of ice sinks. Asbestos in joint compound tape.

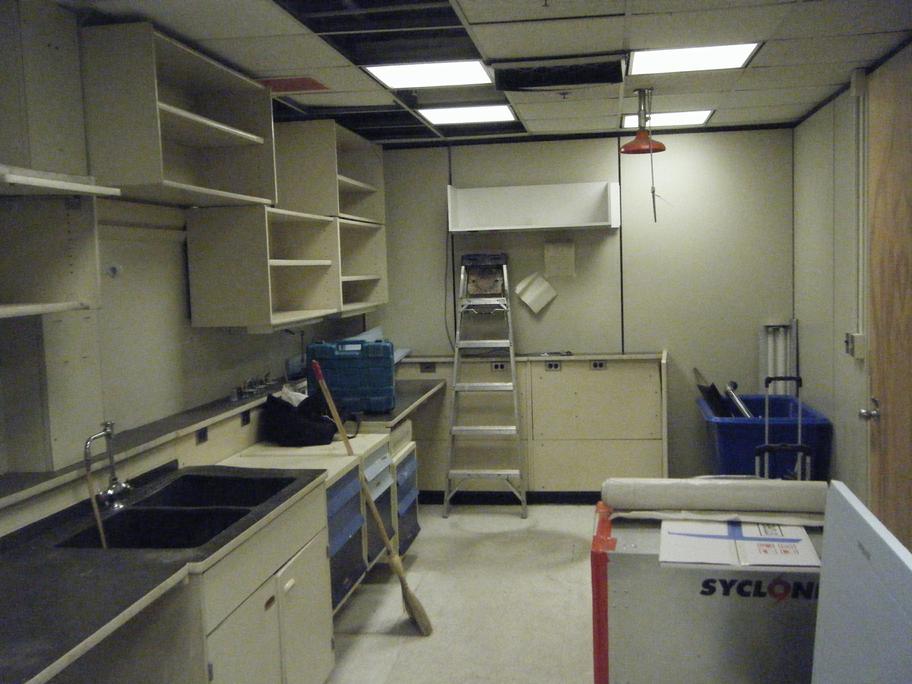

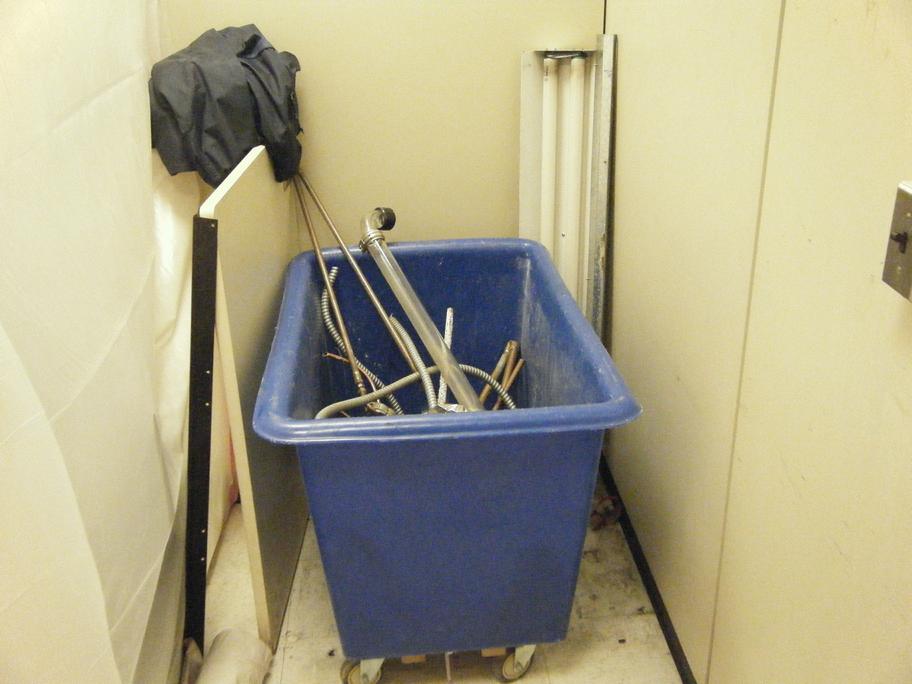

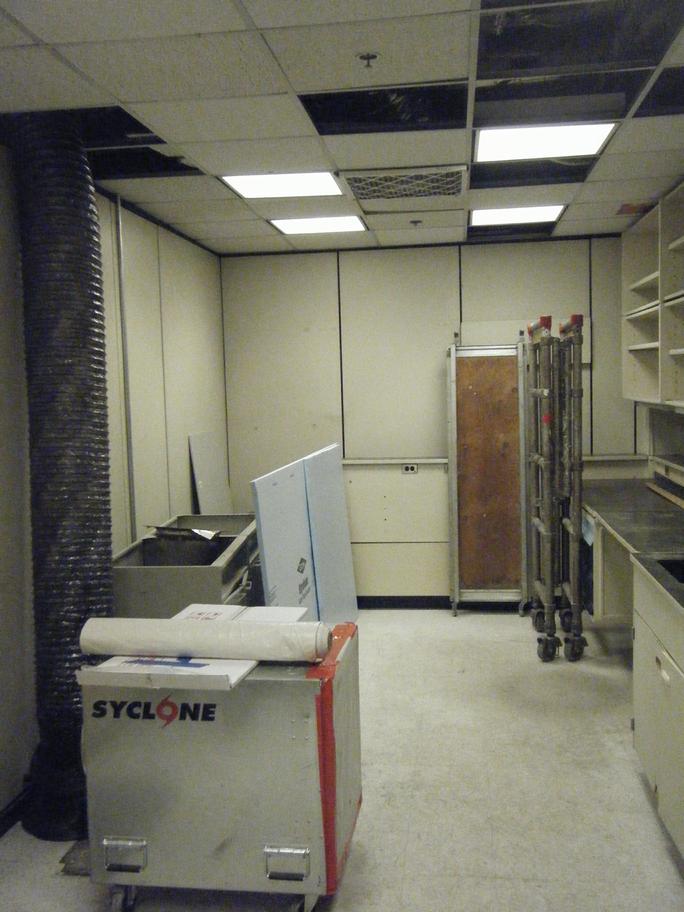

Thu 2-2-2017. Jordan 1071. Day 4. Haul away transite panels, counter top, fume hood pieces. Take down barrier. Must return for Neg Air, scaffold, ladder. Possible future nearby work.

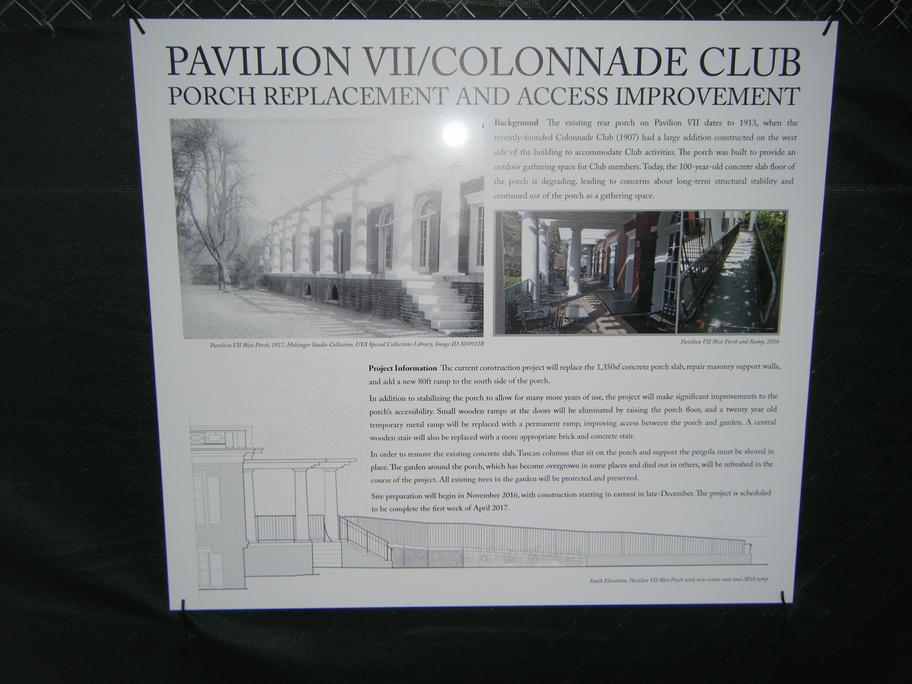

Meeting for Pavilion VII porch replacement. Last work Week 5 late Oct. 2015 to dig asbestos dirt and install ground barrier.

Zehmer 118. Meeting to look at ceiling asbestos, which may be disturbed by HVAC work.

Hospital West Complex. Dispose of 2nd large heavy lead door. 1st door on Fri 1-20.

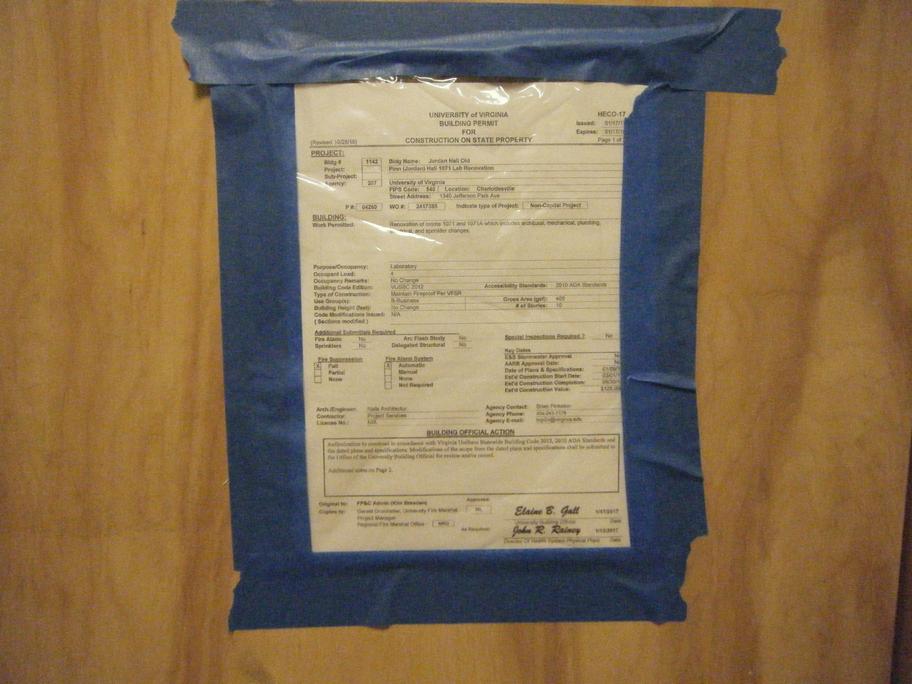

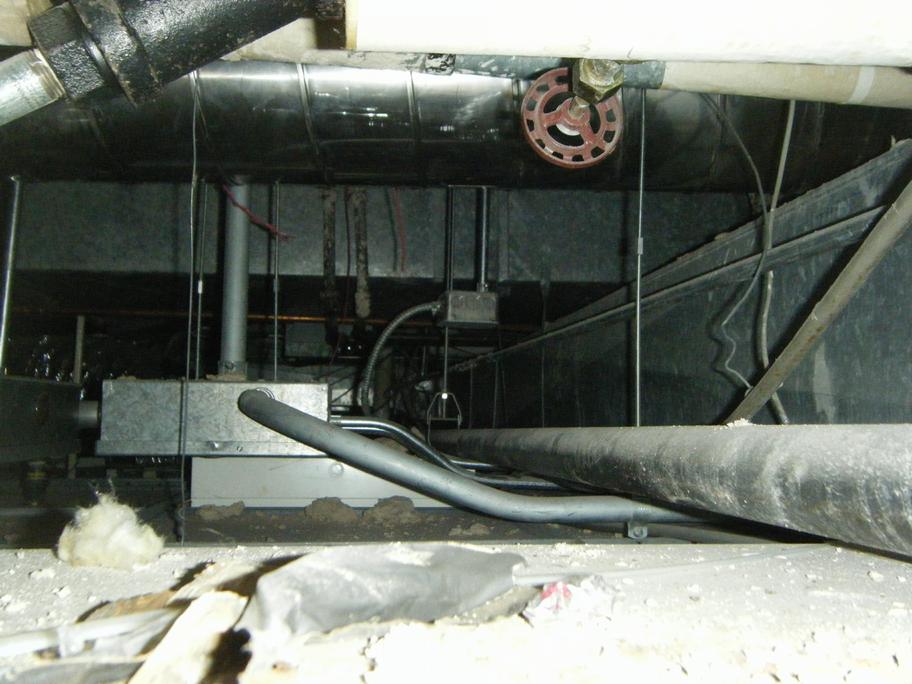

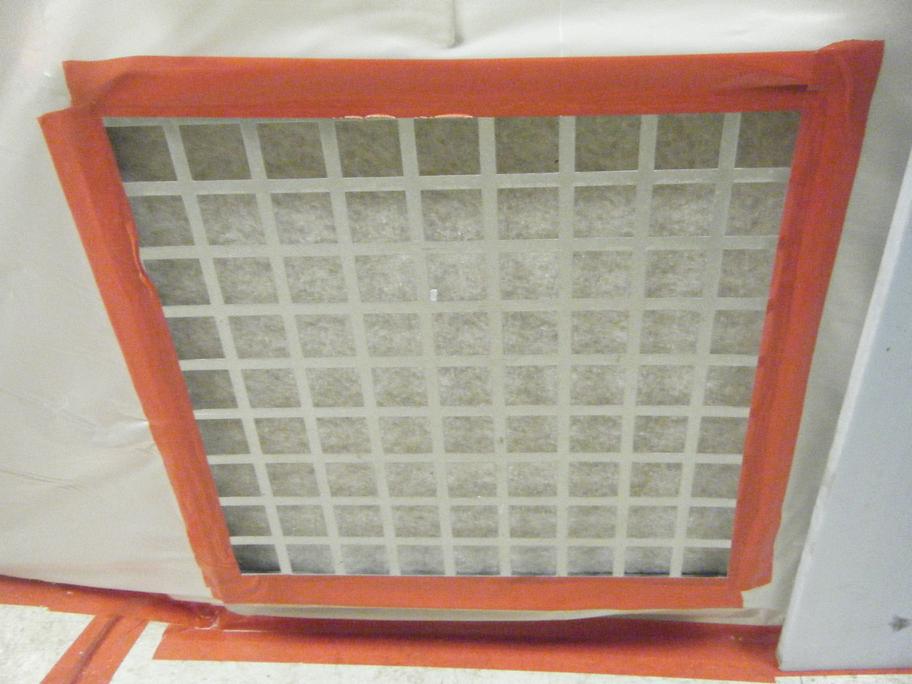

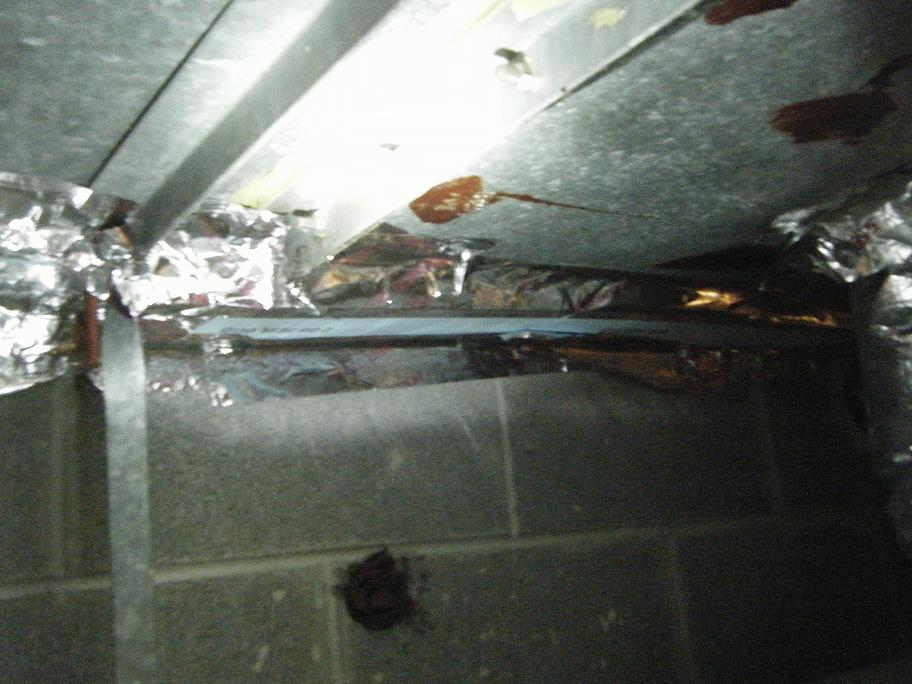

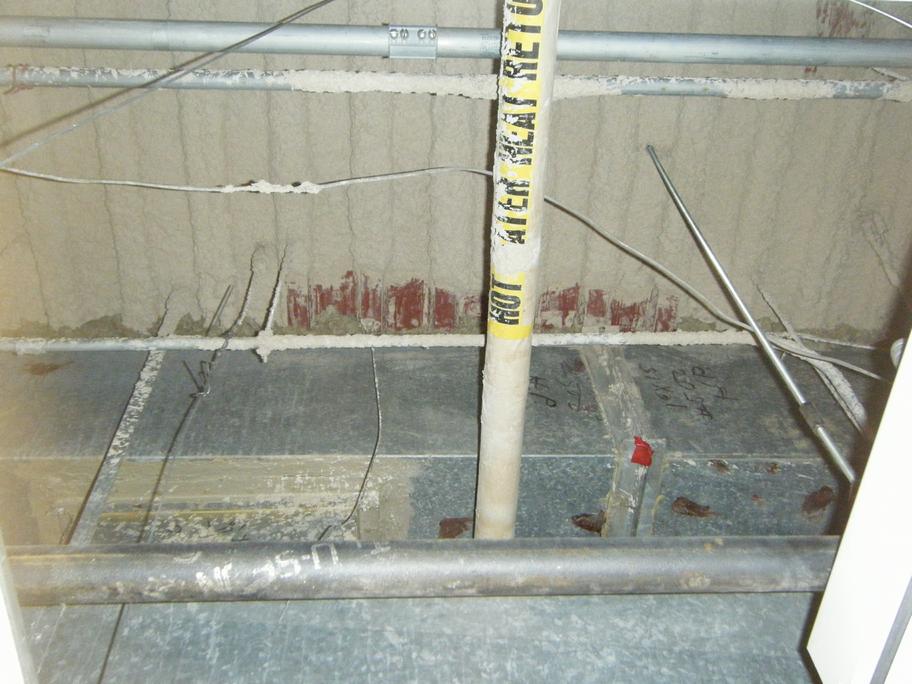

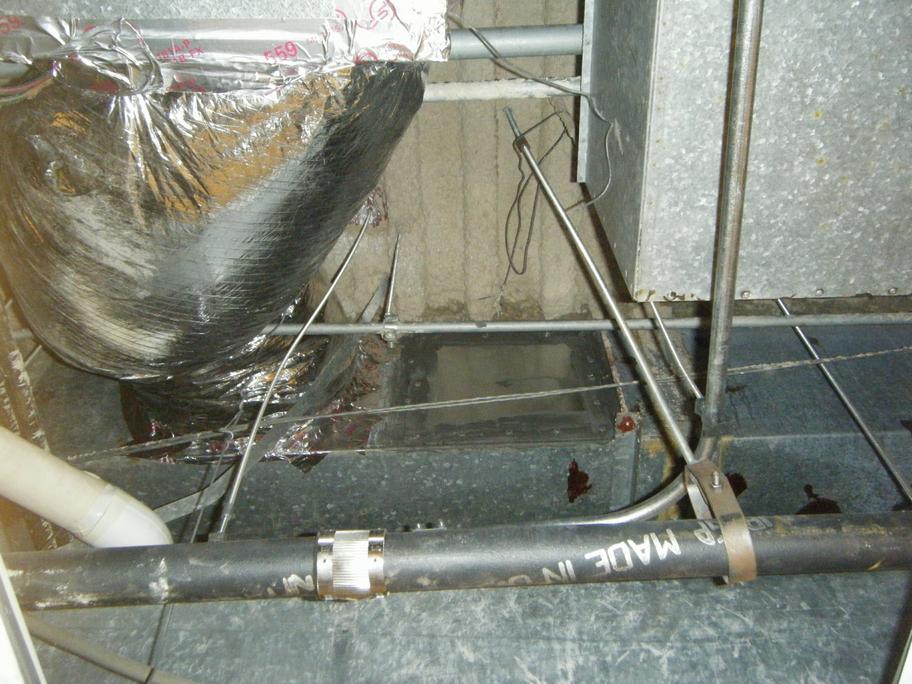

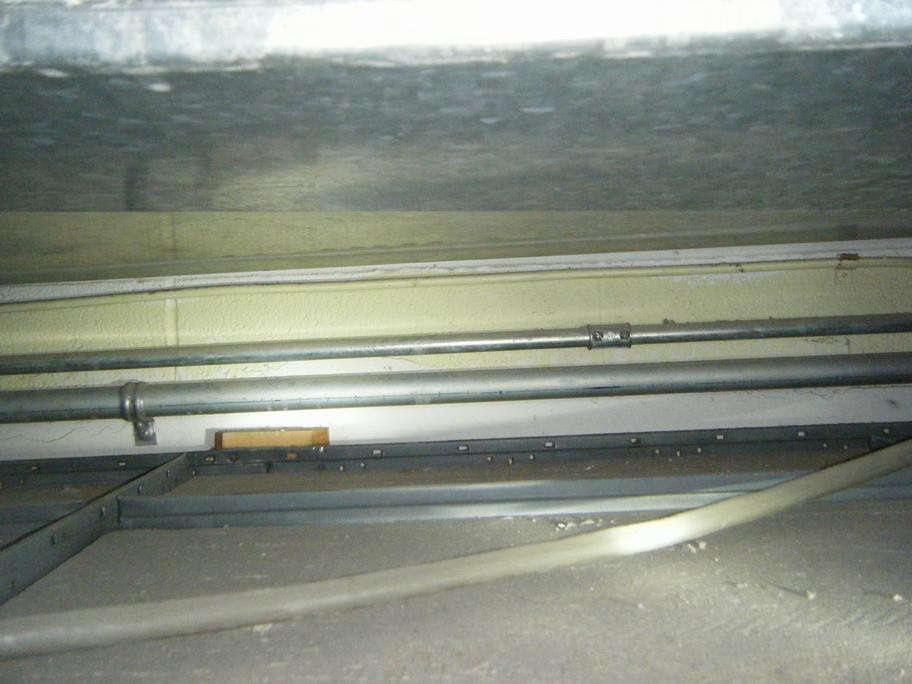

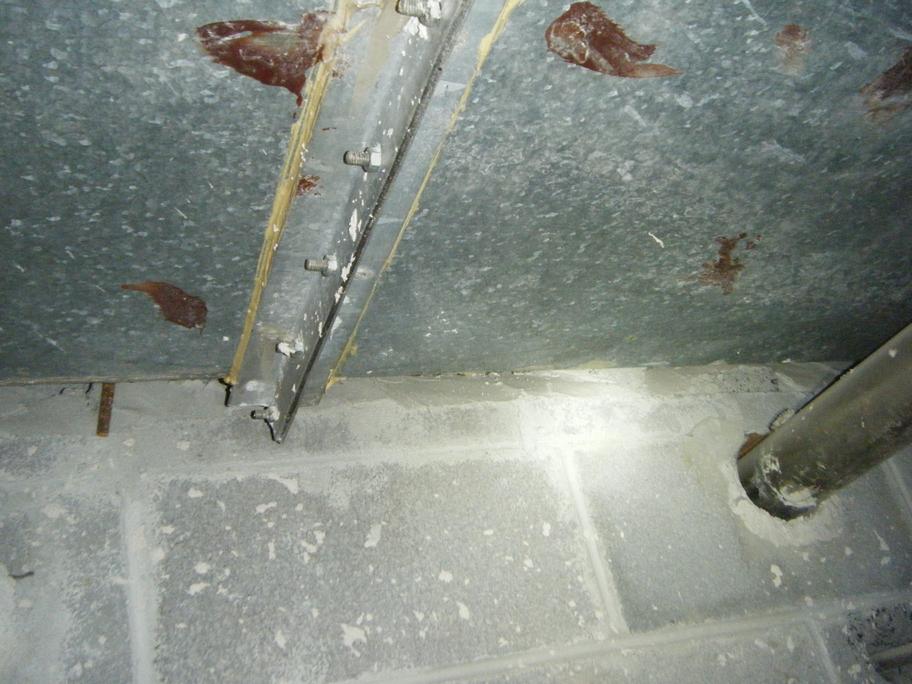

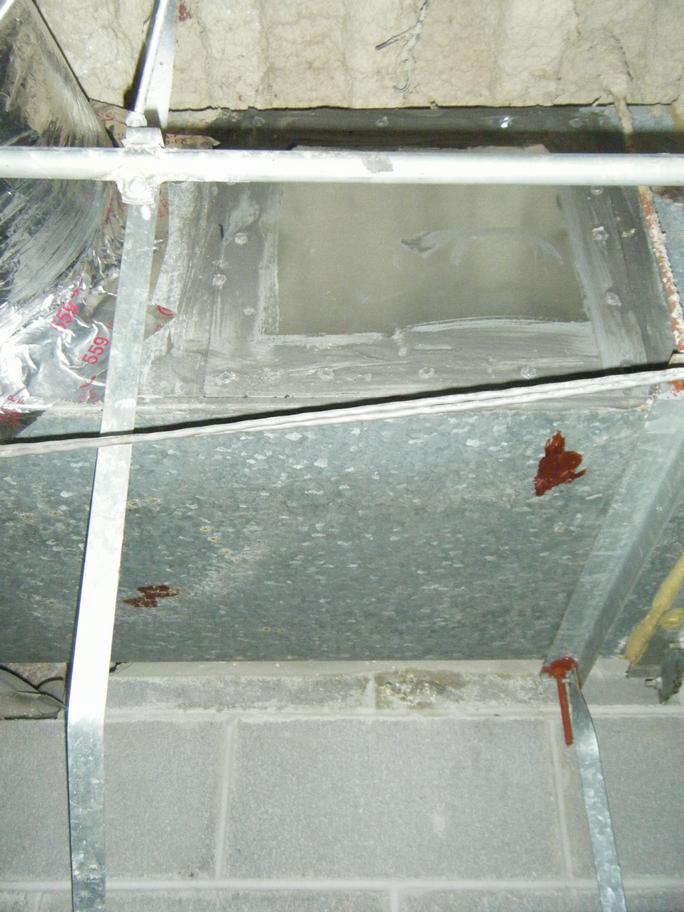

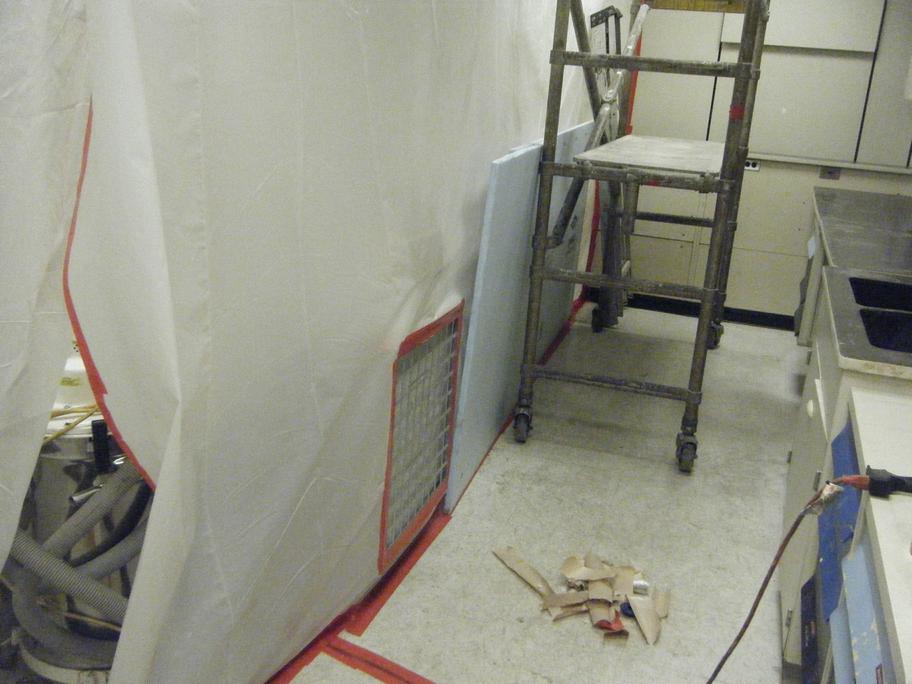

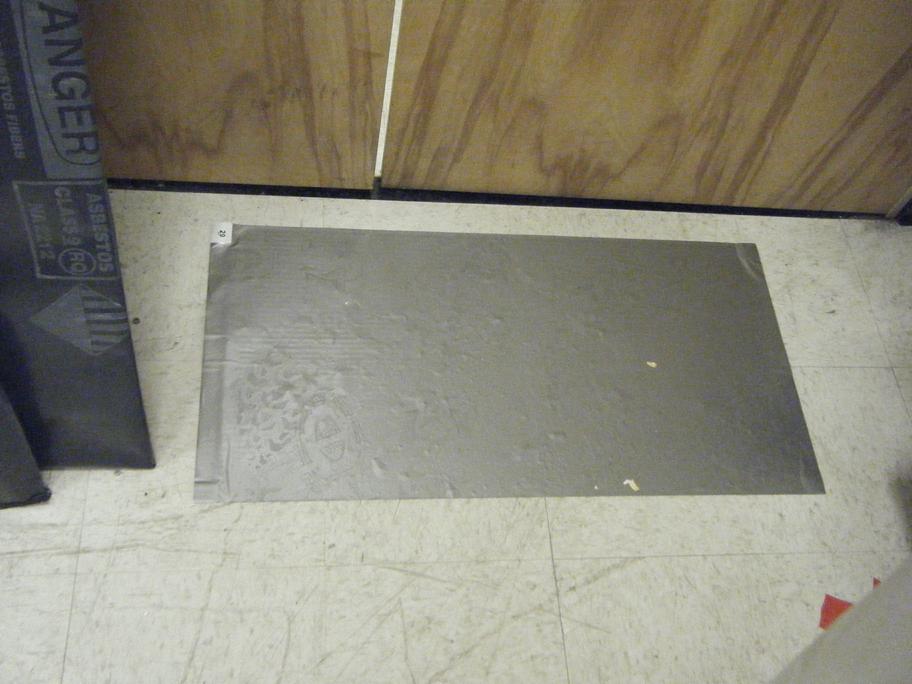

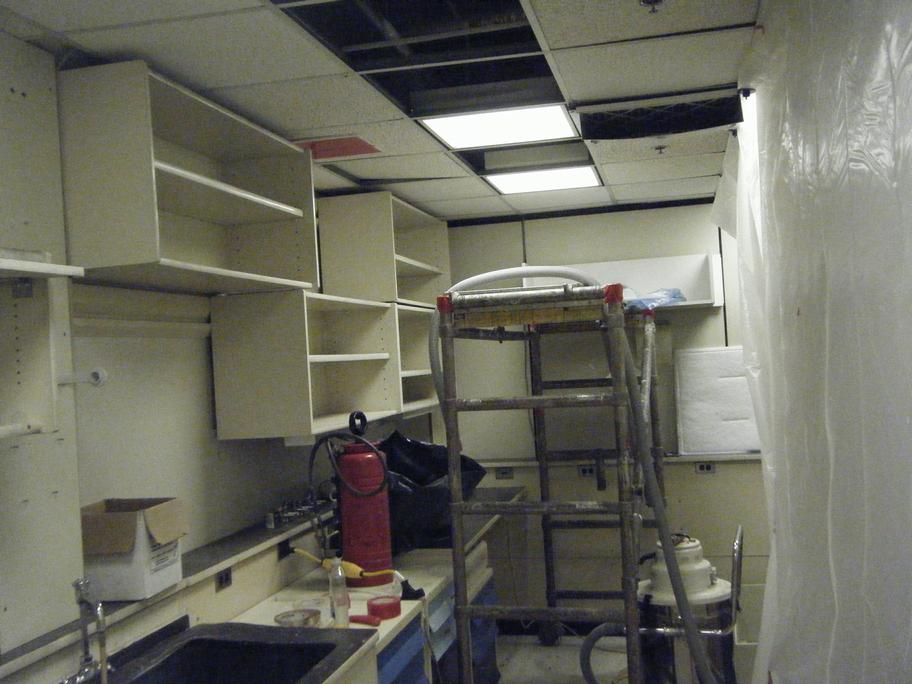

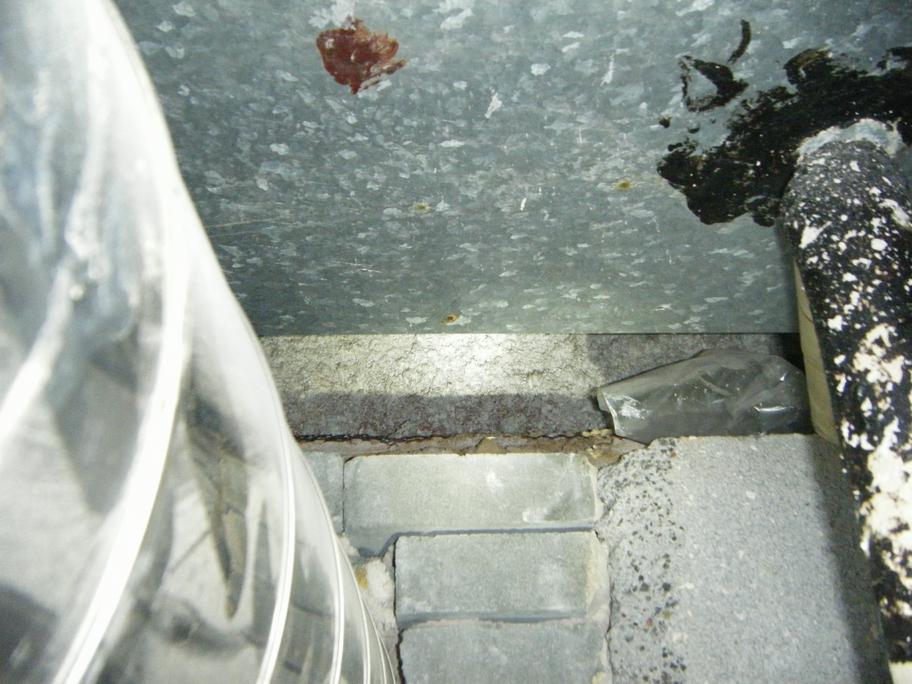

Wed 2-1-2017. Jordan 1071. Day 3. White asbestos in 2 locations behind duct...in a hollow and narrow gap where vertical down T-intersection. Gap between duct and wall is bridged with styrofoam strips and FSK tape. Gap between duct and corrugated ceiling cellulose is stuffed with rock wool. Duct extends into an adjacent room.

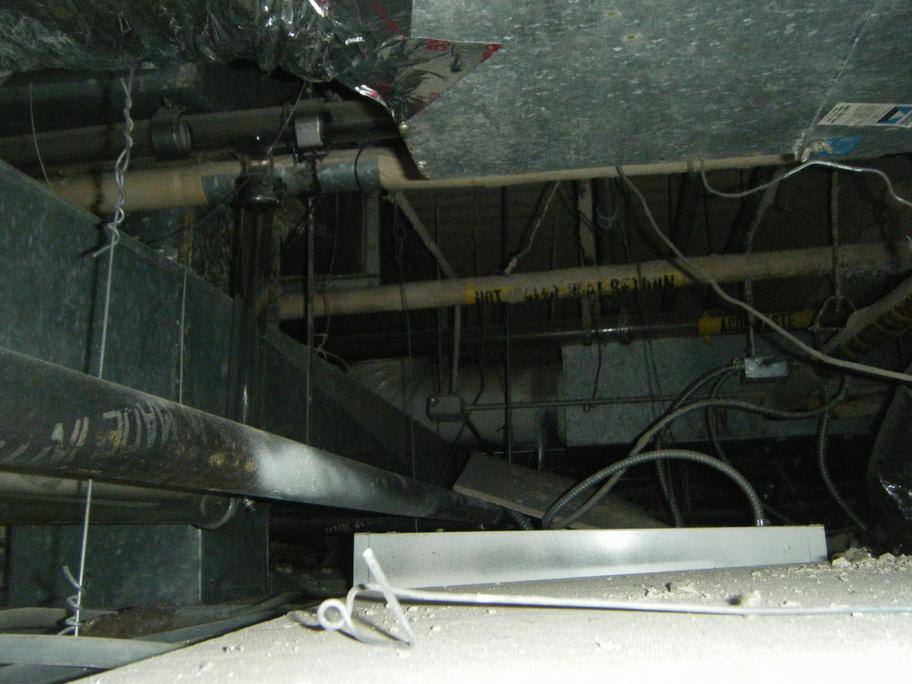

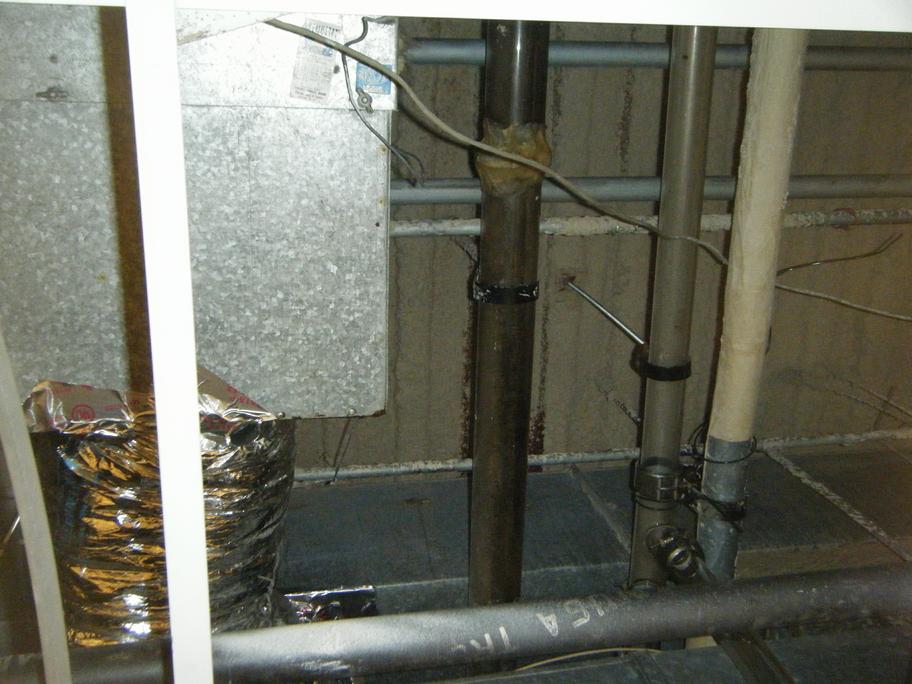

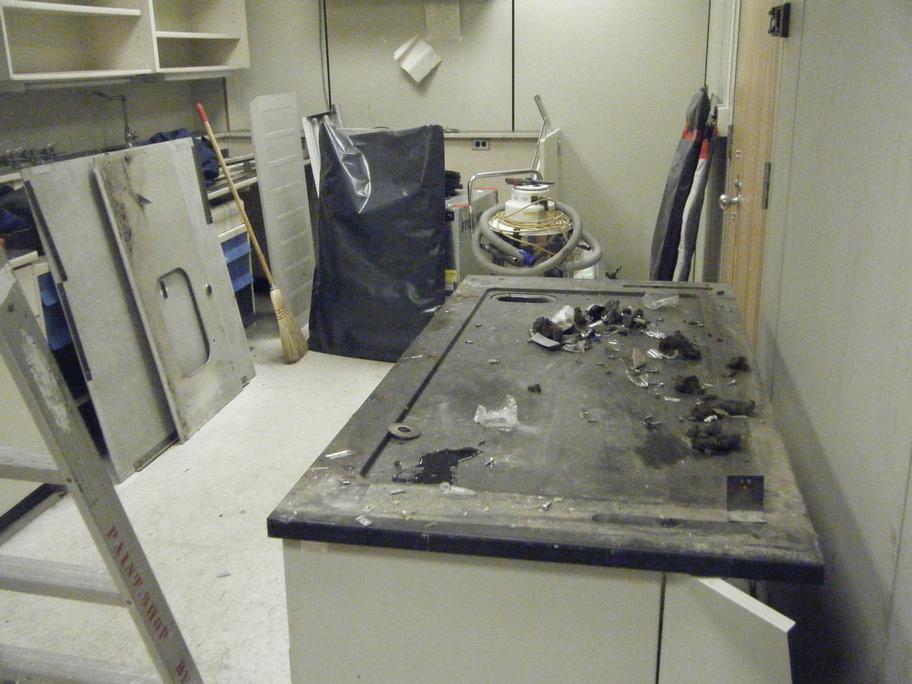

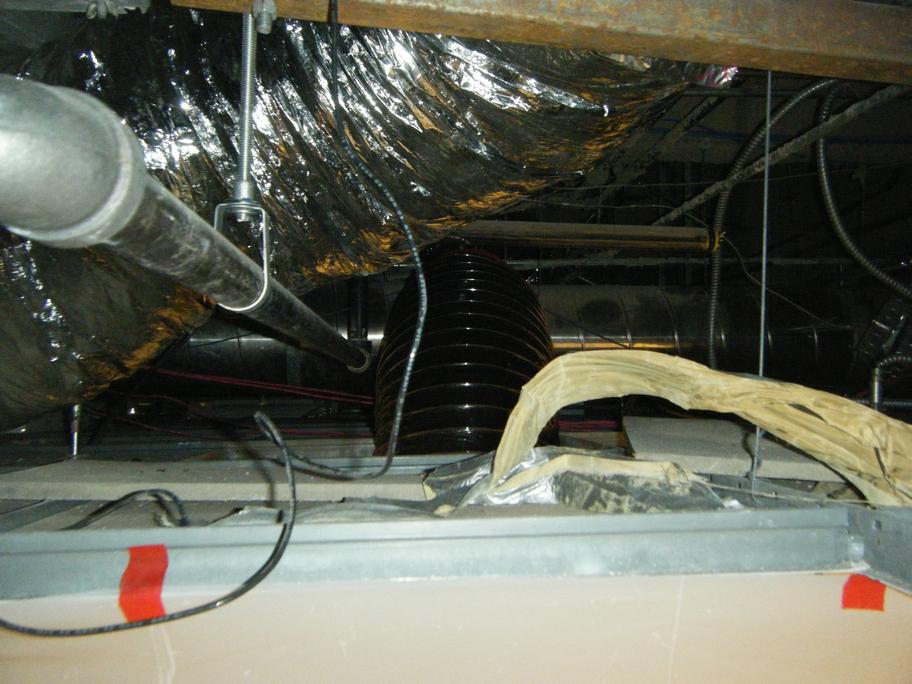

Tue 1-31-2017. Jordan 1071. Day 2. First 3 photos show the work. Labor (2-man crew) is sent to do the job. But description doesn't match complexity of work. So Labor complains to Inspector. At break a department meeting is called about Labor complaining about University Hall last week and the futility of cleaning it. Instead of scraping and taping, now fiber board for the large gaps and rock wool instead of scraping. The meeting is discussed below.

Install proper brackets for banners near Beta Bridge and Fralin Museum on Rugby Road.

Department Meeting. ...What would Undercover Boss say?... Why did it take a meeting to resolve the differences between Labor (2-member crew) and Management (1 supervisor)? The meetings involve the asbestos department (3 people) and the next level Manager. Manager needs a meeting with Labor without Supervisor to figure out the problem. Among the reasons I started this work blog was to push against Management when they dismiss the legitimate concerns of Labor and the stigma of asbestos. (As Undercover Boss) I see how Management has restricted Labor's access to work orders, dashboard, and inputting time. Before the changes two and a half years ago, if the old supervisor was sick or on vacation, phone calls went to Labor who would inform the Inspector and use the work order to get supplies and charge time. Then you could put that on your resume to show management aptitude and real world experience. I see a member of Labor doing the work of Management in this work journal. How is this employee being recruited or promoted according to University policy for employee development? Why must Labor fight with Management to do a good job? So Management threatens to eliminate the asbestos department and nobody is guaranteed to still have a job? There should be an avenue where Labor is appreciated for putting their lives in danger on a daily basis but not trapped in the job forever. Many thanks go to this work blogger for showing the world (and management) what an Asbestos Worker has to deal with. Most definitive archive documentation of University Hall last week in 4-day cleanup. Also the 20-point plan to modernize asbestos department, not implemented since I didn't get the job as supervisor. And here's my Resume.

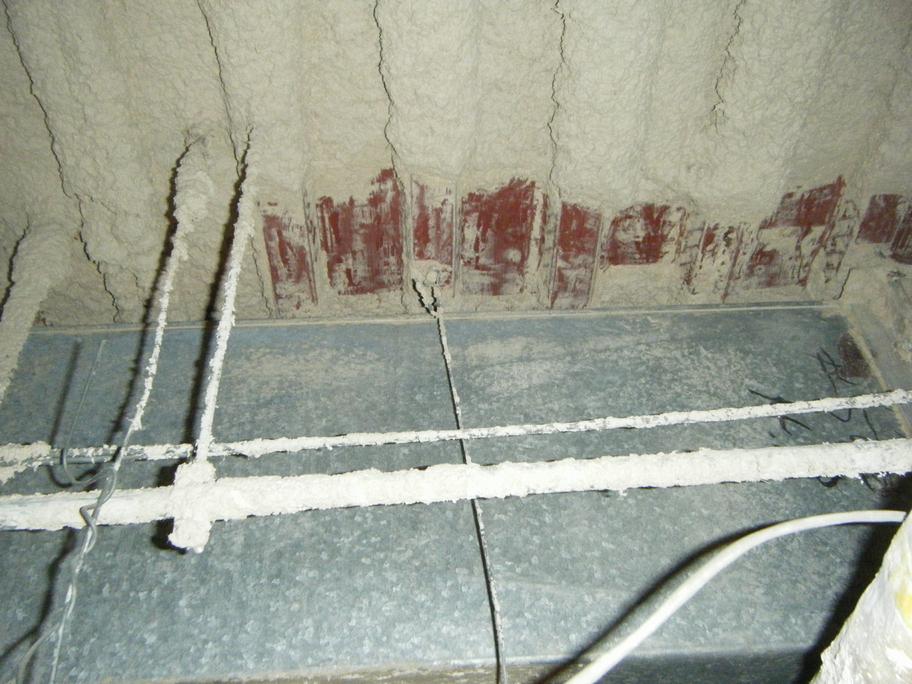

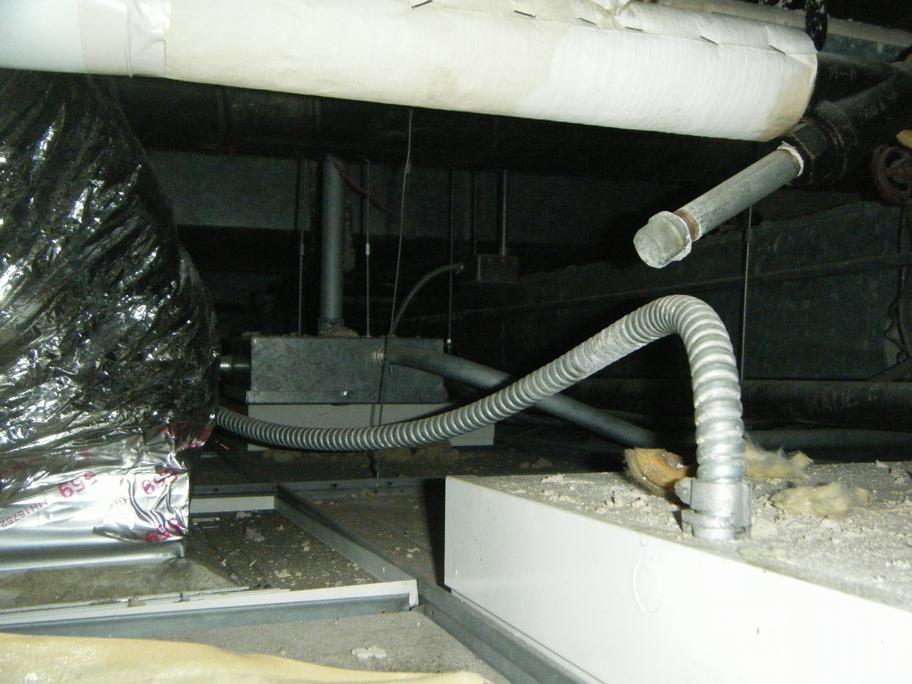

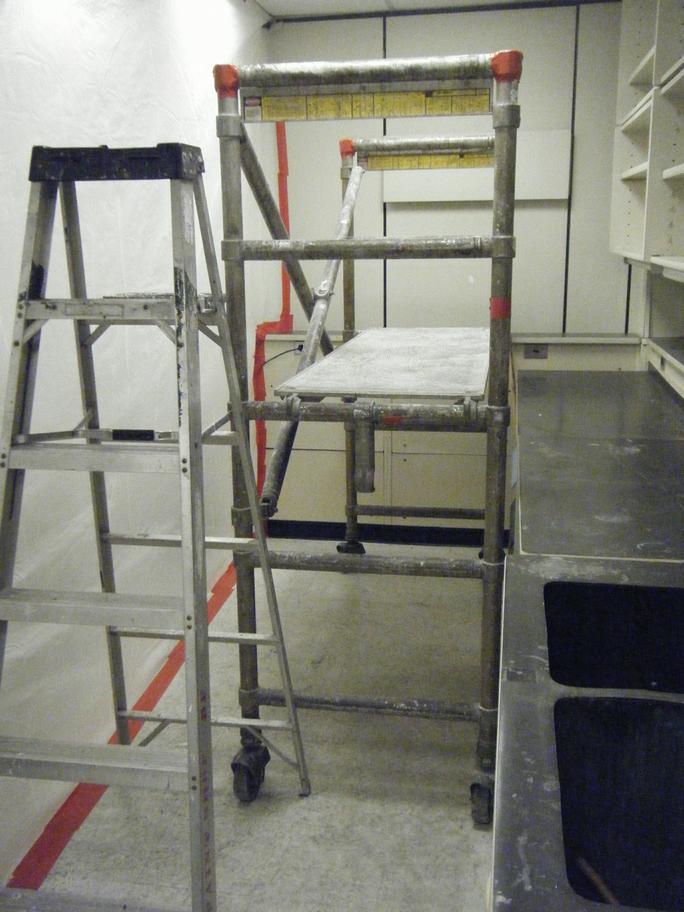

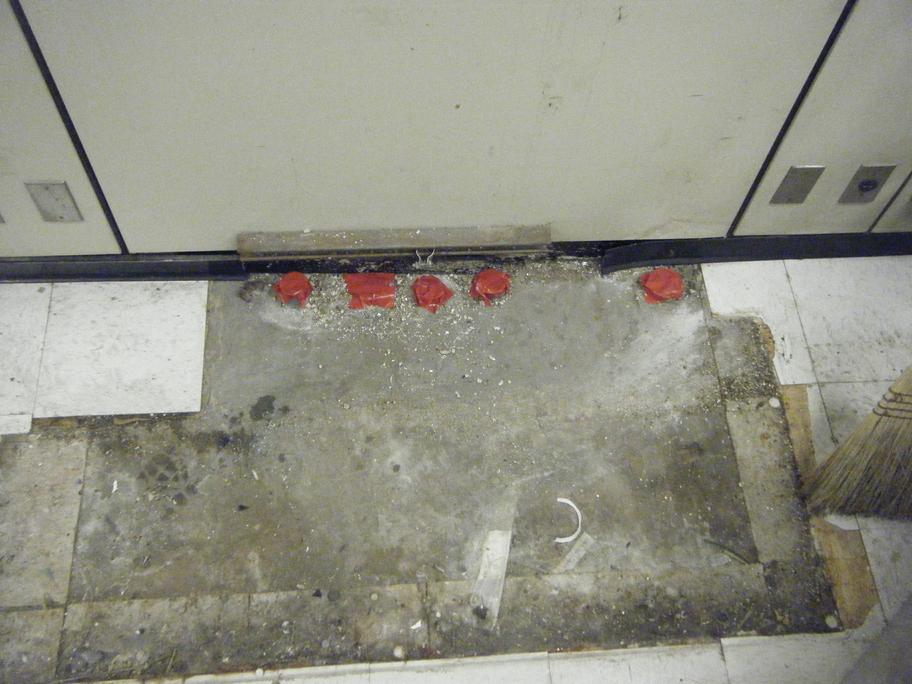

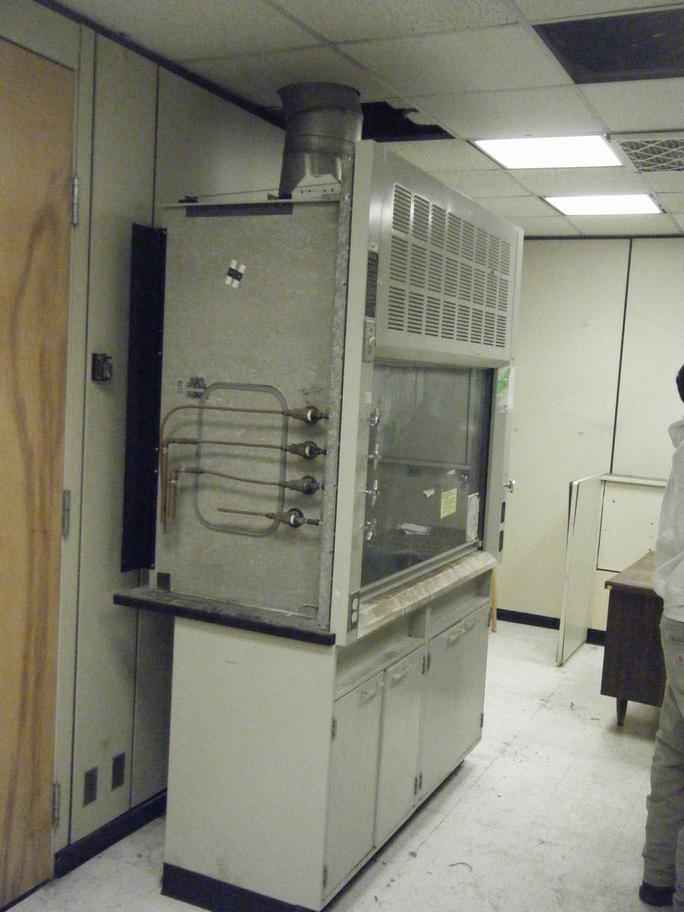

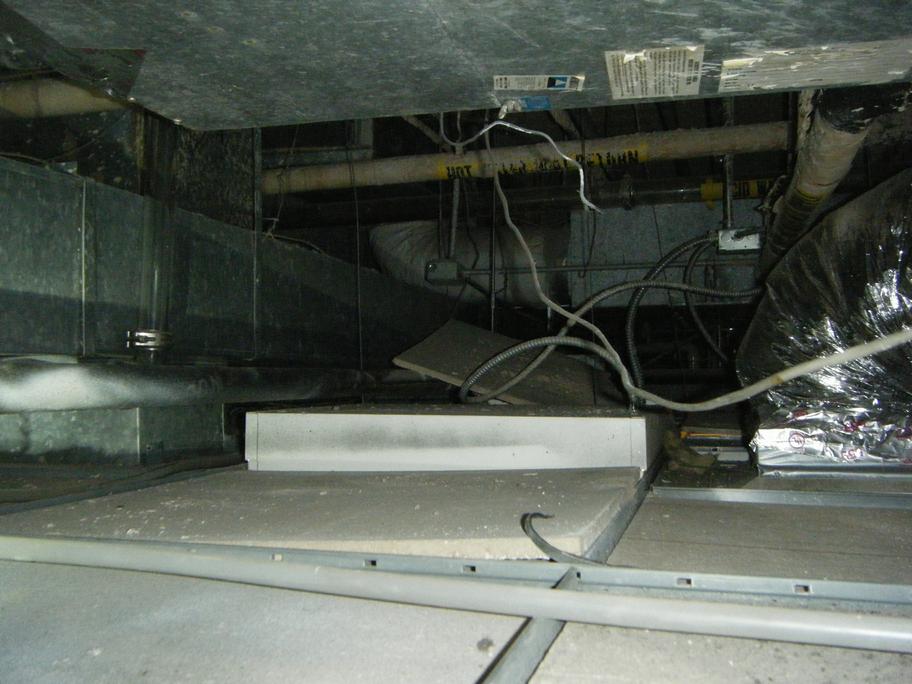

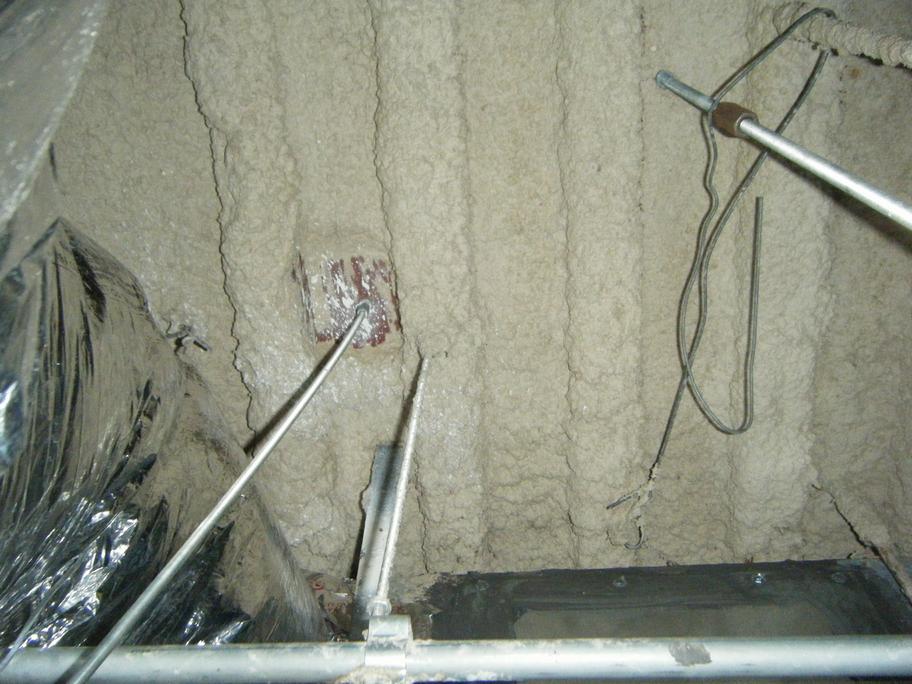

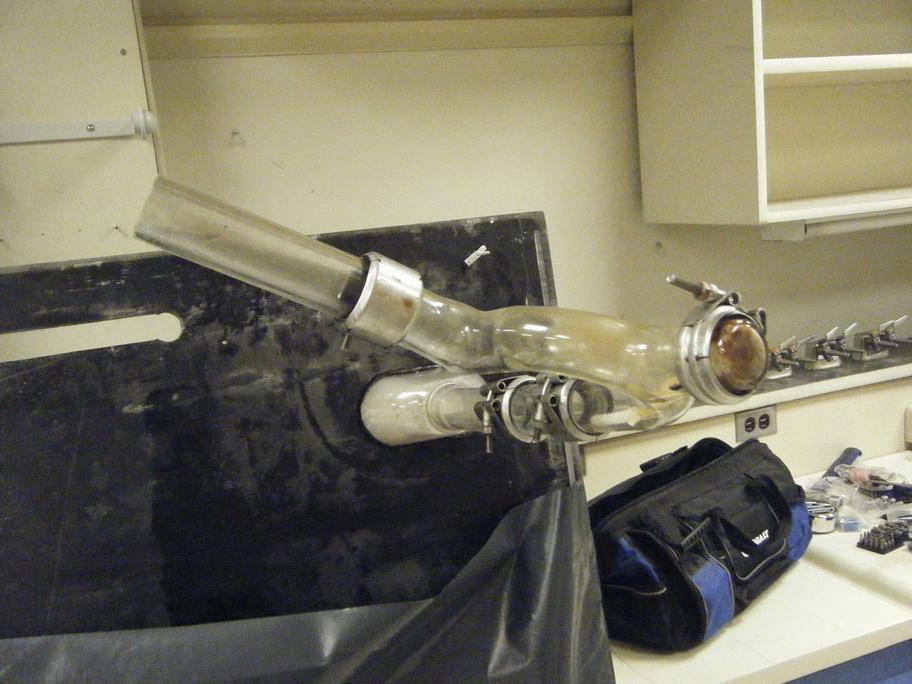

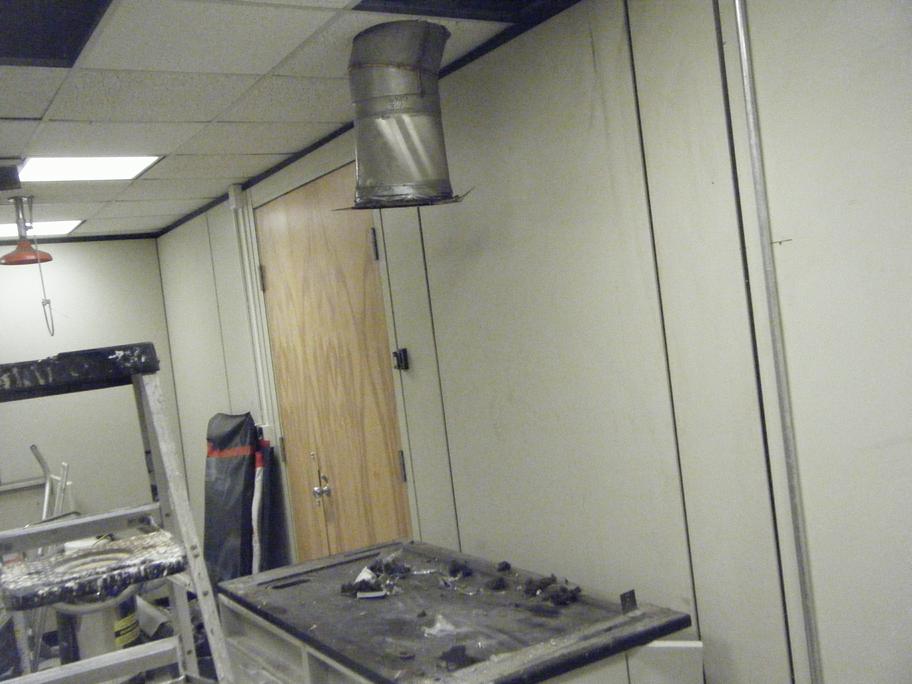

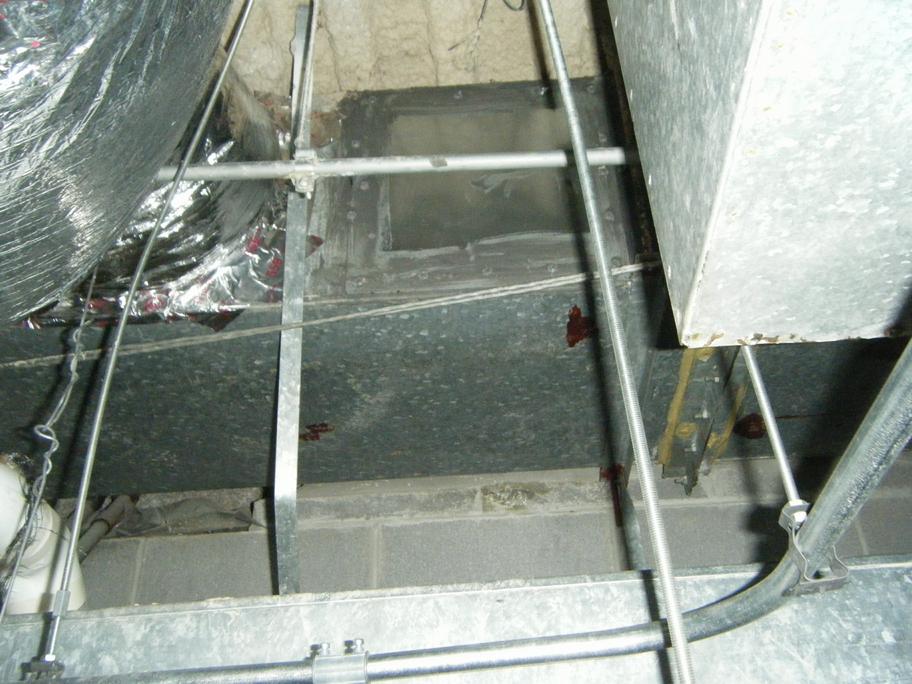

Mon 1-30-2017. Jordan 1071. Fume hood. Scrape cellulose from corrugated ceiling. Tape long square duct at wall and at ceiling to encapsulate asbestos missed in previous abatements.

Payday 2-10. PP3. Leave 150. Timesheets.

1st Week Jan 23 || M 8 | T 8 | W 8 | Th 8 | F 8 || Sa|Su = 40 Hours.

2nd Week Jan 30 || M 8 | T 8 | W 8 | Th 8 | F 8 || Sa|Su = 40 Hours.

Home | Training | Week 67 | 66 | 65 | 64 | 63 | 62 | 61 | 60 | 59 | 58 | 57 | 56 | 55 | 54 | 53 | 52 | 51 | 50 | 49 | 48 | 47 | 46 | 45 | 44 | 43 | 42 | 41 | 40 | 39 | 38 | 37 | 36 | 35 | 34 | 33 | 32 | 31 | 30 | 29 | 28 | 27 | 26 | 25 | 24 | 23 | 22 | 21 | 20 | 19 | 18 | 17 | 16 | 15 | 14 | 13 | 12 | 11 | 10 | 9 | 8 | 7 | 6 | 5 | 4 | 3 | 1&2 | Archives
